Up to eight units on a lot you already own.

The Centre Plan's ER-3 zone allows a building of up to eight units on a single lot, as of right, the number set by the lot's area. Every lot it covers is on this map.

Tap a lot for its address, its area and what the zone allows on it.

Fig. 01 · Every ER-3 lotStill frame

  • In the zone
  • 600 m² or more · allows eight

14,774 lots, each with its address, its area and the units the zone allows on it; 12,246 of them are 600 m² or more. No owner, value or sale on any lot. Source: the municipality's parcel and zoning records and the provincial assessment roll. As of 24 October 2026.

The map opens as it comes into view.
  1. 14,774lots the ER-3 zone coversmeasured the record · as of 24 October 2026
  2. 12,246of them 600 m² or more, where the zone allows eightmeasured the record · the Centre Plan's ER-3 table
  3. 11 mheight, and 10.7 m frontage for a multi-unit dwelling; setbacks and coverage still applymeasured HRM Centre Plan · ER-3

What your lot allows

Four to eight, set by the lot’s area.

HRM's ER-3 table: four units with a backyard suite under 375 m², then one more unit at 375, 450, 525 and 600 m². Frontage, setbacks, height and coverage still apply, so the count is the zone's answer, and the reading of a lot is the lot's.

Fig. 02 · The density scaleHRM · the ER-3 table
Units the zone allows on one lot, by its area; a larger lot still allows eight. Move the handle, or pick a lot on the map and its area lands here.

The zone allowsup to 8

600 m² · the handle wakes with the page

  1. 4 under 375
  2. 5 375–450
  3. 6 450–525
  4. 7 525–600
  5. 8 600 and over

Source: HRM's ER-3 density table, April 2024, in force for the permits the record holds; the count is what the zone allows by area, and one lot's own reading answers for that lot. measured As of 24 October 2026.

Sell, or build

At the rents older buildings ask, sell. At new-building rents, build.

A builder pays for a lot what leaves him his margin after the building's sale; an owner who already holds the lot keeps that upside. Whether it is worth the build is arithmetic on three numbers, and where it says sell, it says sell.

Fig. 03 · Sold today against builtthe ledger · static
The lot sold today, the cash the build asks beyond it, and the equity a finished eight leaves at lease-up, on your inputs; the page looks each answer up and computes nothing.
The area
Marks: CMHC's average in Dartmouth North, all tenancies, $1,653; the builder's list rent $2,200.
Sold today, before tax$600,000
Built: your cash in during the buildbeyond the lot, by the lender's rule$64,964–$458,542
Built: your equity at lease-upafter the refinance$242,555

At this rent the building is worth less than it costs by $54,788: the numbers say sell.

Everything in $2,417,056 · the insured mortgage $2,119,713 · income after the mortgage in year one $10,738

The controls wake when the table of results has loaded; shown, the starting point: a lot worth $600,000, leased at $2,000, in Dartmouth. Source: the desk's engine, every combination of lot value, rent and area run in advance; two of the eight at CMHC's affordable rent, the builder's price, design and legal lines held fixed inside everything-in. inferred As of 15 October 2026.

Sixteen months

Nothing is paid before the contracts.

Two firms for about sixteen months, one insured loan from the first draw to the long mortgage, and the fee paid from the refinance at the end, not before.

Stops are built in: the lender, the builder's template, the permit or the commitment can each say no, and so can you, at no cost before the contracts at the end of the first month. As the builder has run it twice; its last six went from the lot to a finished building in ten months. inferred the builder's two last schedules · as of 15 October 2026.

  1. The decision months 0 to 1 An hour in a finished building with the builder and with us, the template check on your lot, the broker's term sheet with every guarantee on it, your lawyer and accountant on the numbers.
  2. Drawings, the permit, the commitment months 1 to 4 The builder's drawings on its template; the permit; the CMHC application through the broker. If either is refused the contracts fall away and you owe the design and application costs to that point, about $45,000 to $60,000.
  3. The build months 4 to 13 The builder's own crews, no subcontractors; the lender advances against inspected work; ten per cent of every payment held back under the Builders' Lien Act.
  1. Lease-up months 13 to 16 Eight units to market, priced against every listing in the city; a manager, or you, runs the building from here.
  2. The refinance month 16 The insured mortgage replaces the construction loan on the leased building, sized to the signed leases; your cash comes back; the fee is paid from it.

An eight on an ER-3 lot is built as of right, so the building permit is the one approval it waits for; the planning row in the figure is the discretionary path a by-law-compliant project skips.

The wait is measured from the municipality's own record, by the median, and half of the cases behind it took longer.

Fig. 04 · How long approvals take Medians
Measured from HRM’s own records: the discretionary path, stage by stage. A project that complies with the by-law skips the first row.
Median days to a decision~15 months total
Measured median approval times in Halifax Regional Municipality, by stage, with the number of cases behind each median, as of June 2026.
StageCasesMedian
Planning approval — development agreement110366 days
Building permit — new 5+ unit building25978 days
Discretionary path, both stages—~15 months

Source: what HRM permits actually take — Helio’s measured read of HRM’s permit and planning records. Medians as of June 2026; half of the cases behind each one took longer.

What has been built

Kulak Construction has built nine buildings on single lots since February 2020.

Two of them stand on ER-3 lots: the six at 80 Cannon Terrace and the eight at 46 Primrose Street, each permit on the municipal record, each lot's area and the units it allowed beside it, and the buildings themselves at kulak.ca. The walk through the six is below.

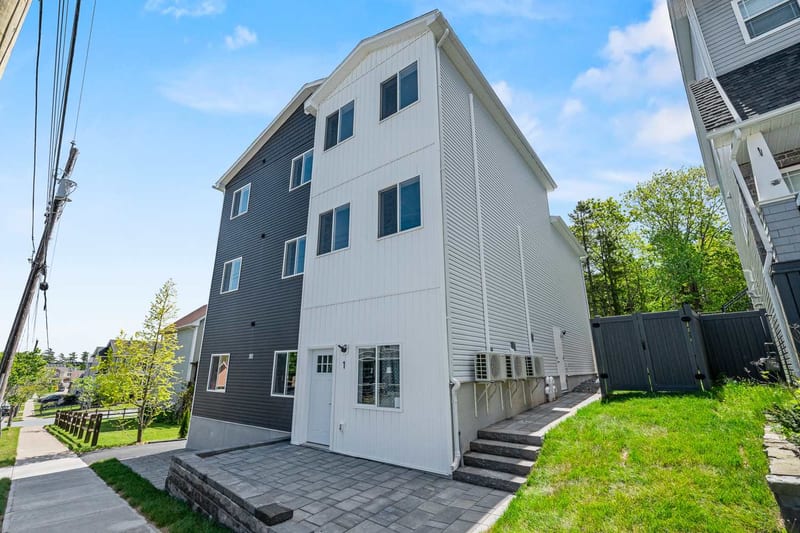

80 Cannon Terrace from the street: three storeys, six units, finished 2026
Record01

80 Cannon Terrace, Dartmouth

  1. Units built · the zone allowed6 · up to 6
  2. Lot area469 m²
  3. Building permitBPRES-2025-13725, issued 6 November 2025
  4. Lot bought · finishedAugust 2025 · spring of 2026
  5. What happenedFinished spring 2026; sold June 2026 to a company

Where to check: the permit on HRM's record, by its number · the deed on the provincial register · kulak.ca. measured As of 15 October 2026.

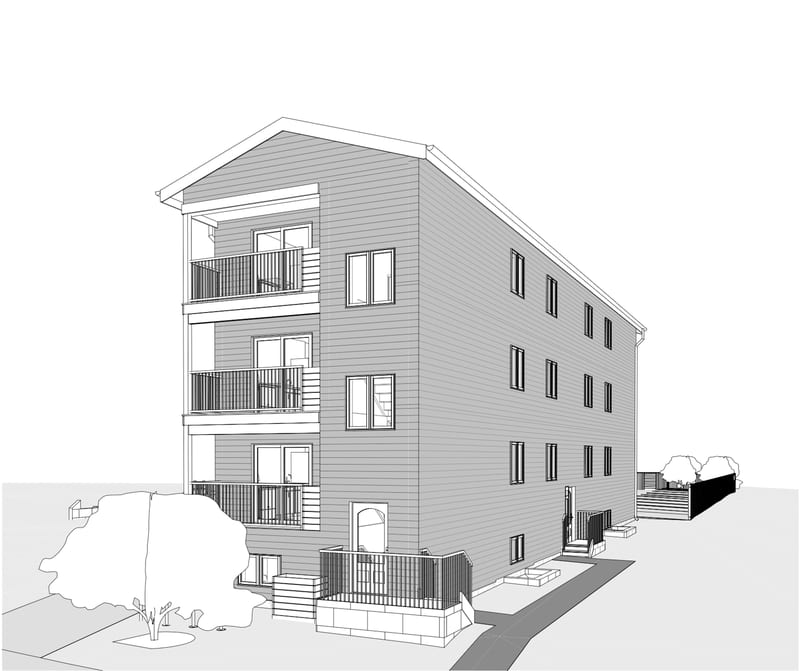

The eight at 46 Primrose Street as the builder drew it: a drawing, not a photograph
RecordThe builder’s drawing02

46 Primrose Street, Dartmouth

  1. Units built · the zone allowed8 · up to 8
  2. Lot area1,273 m²
  3. Building permitBPRES-2026-06370, issued
  4. Lot bought · expectedMarch 2026 · before the year is out
  5. What happenedRising, expected before the end of 2026; to be kept and refinanced rather than sold

Where to check: the permit on HRM's record, by its number · the deed on the provincial register · kulak.ca. measured As of 15 October 2026.

Fig. 05 · The walk through the six21 frames · swipe, or the arrows · photographs: Kulak Construction, 15 October 2026

  1. 80 Cannon Terrace from the street: three storeys, six units, finished 2026

    80 Cannon Terrace from the street: three storeys, six units, finished 2026

  2. The side from the street, with the houses of the street behind

    The side from the street, with the houses of the street behind

  3. The rear: the parking court, the retaining wall and the fence

    The rear: the parking court, the retaining wall and the fence

  4. A finished two-bedroom: the kitchen, with the window to the street

    A finished two-bedroom: the kitchen, with the window to the street

  5. The kitchen: stainless appliances, white cabinets, the stone-look splashback

    The kitchen: stainless appliances, white cabinets, the stone-look splashback

  6. The kitchen run, with the dishwasher and the range

    The kitchen run, with the dishwasher and the range

  7. From the kitchen to the unit door

    From the kitchen to the unit door

  8. The kitchen from the living room

    The kitchen from the living room

  9. The living room, looking to the kitchen

    The living room, looking to the kitchen

  10. The living room and its window

    The living room and its window

  11. The living room and the kitchen together

    The living room and the kitchen together

  12. The hall to the bedrooms

    The hall to the bedrooms

  13. The hall, with the bathroom ahead

    The hall, with the bathroom ahead

  14. The first bedroom

    The first bedroom

  15. The first bedroom: the wardrobe and the window

    The first bedroom: the wardrobe and the window

  16. The first bedroom, from the door

    The first bedroom, from the door

  17. The second bedroom

    The second bedroom

  18. The second bedroom: the wardrobe

    The second bedroom: the wardrobe

  19. The bathroom: the glass shower, the vanity

    The bathroom: the glass shower, the vanity

  20. The bathroom: the vanity and the light

    The bathroom: the vanity and the light

  21. The laundry closet: a stacked washer and dryer, and the water heater

    The laundry closet: a stacked washer and dryer, and the water heater

What can go wrong

14 things that can go wrong, and what stands against each.

An eight on a single lot is a large thing to ask of anyone: an insured mortgage of about two million dollars, two firms for about sixteen months, and a fee. This is what we would want to know in your place.

  1. The build costs more

    The owner's cash during the build rises.The building's price is stated in the contract on signed drawings; changes the owner orders are priced at a stated rate; unforeseen ground by a stated rule with a cap.

  2. The build takes longer

    Interest runs on; the lease-up slips a season; the rent test moves.The builder's own crews and its last two schedules; a completion date in the contract with the cost of lateness set against the builder; draws only against inspected work.

  3. The rents come in lower

    The lender sizes the mortgage to the signed leases, so the loan is smaller and the owner's cash left in larger.The calculator shows the downside at the rent you choose; nothing obliges anyone to start before the builder's eight has leased.

  4. The rate rises before it locks

    About $30,000 of the owner's cash per tenth of a point.The window is from the decision to the lender's commitment; a lock can be bought.

  5. The lender advances less than expected

    The owner's cash during the build moves from one figure to the other.The broker settles the rule before anyone signs; the calculator shows both.

  6. The permit or the commitment is refused

    The project stops before it starts.The contracts are conditional on both; the owner owes the design and application costs to that point, about $45,000 to $60,000, and nothing to the builder.

  7. A neighbour appeals

    About three months' delay.As of right under the Centre Plan; in the builder's experience the appeals were dismissed; the schedule allows for it.

  1. The water-connection charge rises

    About $150,000 more on an eight if the proposal passes.A permit is assessed under the schedule in force when it is issued, as we read Halifax Water's rule.

  2. An existing mortgage on the lot

    Its balance joins the owner's cash during the build.Read from the register before anything is signed.

  3. A tenant in the house

    Nothing starts until the house is empty.We do not approach a tenanted house; the law on ending a tenancy for demolition sets the date.

  4. The builder fails mid-build

    The worst case on this list.The lender's draws mean the money is advanced only for work done; the lien holdback; builder's risk insurance during the build; the warranty; the contract's terms for completion by another contractor; and, if the owner's lawyer asks for it, a bond or letter of credit.

  5. The affordability commitment is lost

    The loan reverts to full recourse and forty years.two units of eight at the affordable rent, reported annually; the commitment is the owner's to keep and simple to keep.

  6. Values fall when the owner wants out

    The sale price is lower than the numbers show.No one is obliged to sell; the loan is amortized over fifty years and the building covers it at the signed rents; the timing stays the owner's.

  7. Our interests

    The owner is advised by people paid when they build.The fee is stated and paid last; we say when selling is better; we earn nothing on a sale unless separately engaged; the builder's own lots are its own; the owner's lawyer and accountant read everything before signing.

Start

Ask for the reading of your lot.

Pick it on the map, or type the address. The reading reaches you by e-mail within one business day: what the lot allows, what a building on it costs everything in, what you would put in and own, and whether the numbers say build or sell.

Helio reads the lot, brings the financing through a broker and stays on the file to the day the units lease. Kulak Construction designs the building to its template and builds it with its own crews at a price stated in its contract. Neither takes a share of your building, and nothing is paid before the contracts.

902 707 5183 · Lloyd Liu answers it himself

Nothing on this page is a promise of rent, value or return.

Sources: Kulak Construction's own record; the parcel register; CMHC MLI Select, as published; the Centre Plan, as published; arithmetic on the figures named in the sentence; Halifax Water's regional development charge schedule. As of 12 October 2026 to 15 October 2026.

The reading of your lot.

Free, by e-mail, within one business day.

Received.

The reading of the lot reaches you by e-mail within one business day, and Lloyd calls to hear what you want from it.
